Guide · CK Electric and Sons

Panel and service upgrades: 100A to 200A, explained

You need a bigger service when an NEC load calculation of your house, plus what you’re adding, comes out above the main breaker’s rating, or when the panel itself is a brand or in a condition that has to go. A 100 A to 200 A upgrade means a permit, a request to SDG&E or SCE, and a scheduled disconnect and reconnect; SDG&E says its side can take several weeks. Run the numbers first: a 2,000 ft² gas-cooking house with central air fits a 48 A EV charger on 100 A under the NEC 220.83 text.

By Shane Farmer and CK Electric and Sons · CSLB #354550Updated 17 sources

The short version
  • The deciding number is the NEC 220.83 or 220.87 load calculation, not the size of the house or the age of the panel.
  • Federal Pacific Stab-Lok and Zinsco panels get replaced because of the equipment, whatever the load.
  • SDG&E asks for your current and proposed panel size and added loads; it says the process can take several weeks.
  • A service change needs a city permit and an inspection before the utility reconnects; Laguna Niguel wants the utility service order first.
  • Load management for EV chargers (NEC 625.42 and 220.70) and circuit-sharing devices can avoid an upgrade when the math is close.
  • Solar on a 200 A panel with a 200 A main is limited to 32 A of inverter current by the 120 % rule.

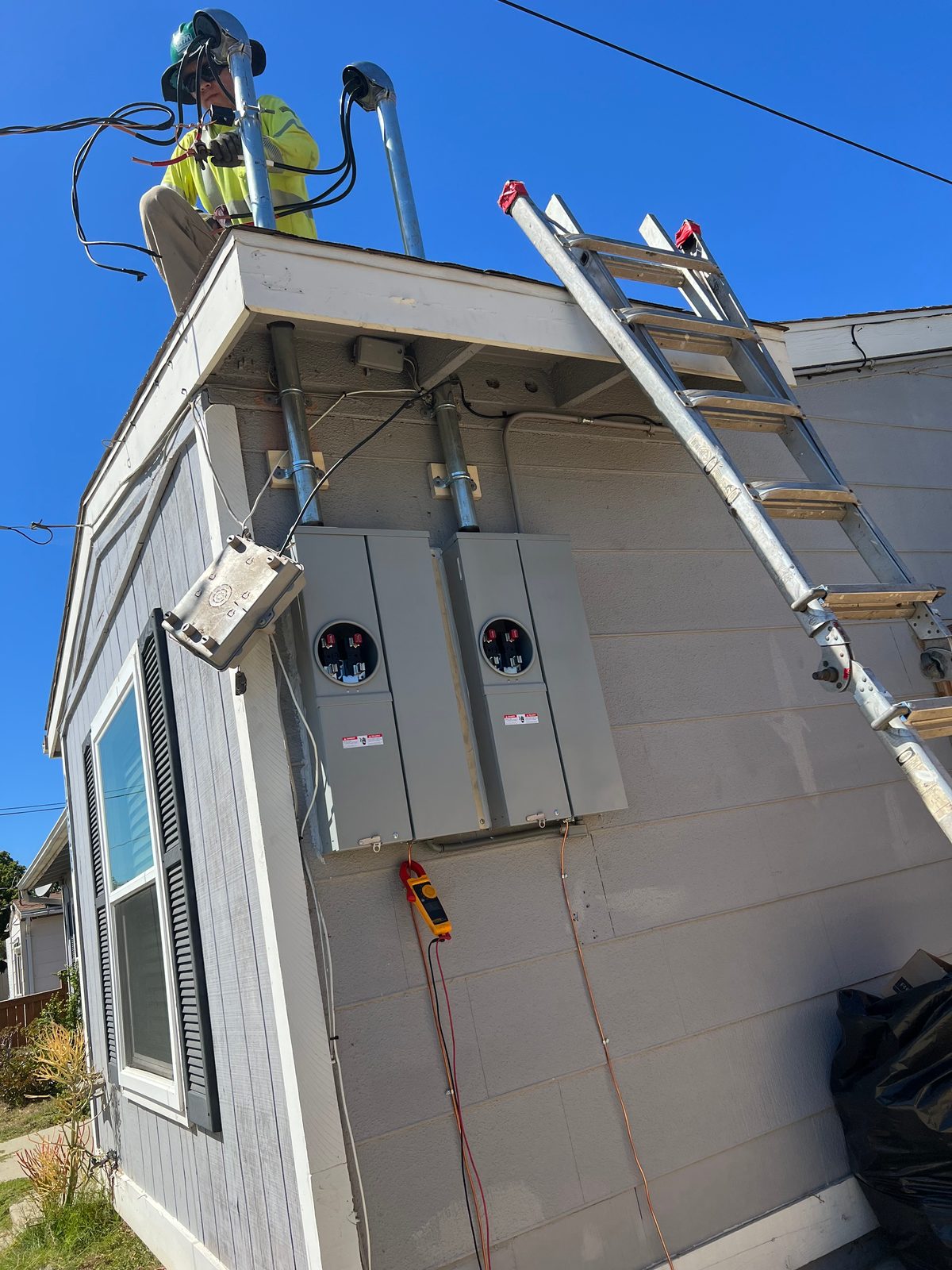

A small house with two new meter sockets on the wall, a ladder against the roof and an electrician working at the service mast
From one of Shane's jobs: service upgrade underway, new meter sockets set

Do you need a panel upgrade at all?

There are two kinds of reasons, and they lead to different jobs. The first is capacity: the NEC load calculation for everything in the house plus the new EV charger, heat pump, induction range or ADU comes out larger than the service rating. The second is the panel itself. That covers Federal Pacific Stab-Lok and Zinsco panels, which insurers recommend replacing no matter how lightly they’re loaded, plus corrosion, heat, scorch marks, or a panel with no main breaker.

The signs worth acting on:

  • A load calculation over the rating. Our panel load calculator does the 220.83 and 220.87 math and prints every line.
  • A flagged brand. The problem panel checker shows what the evidence is for each one, and what kind of evidence it is.
  • Rust or water stains on the panel or meter, a breaker that’s warm, or a buzz. Those are urgent.
  • No main breaker. The 2020 NEC stopped allowing new service panels without one; an existing split-bus panel is legal but due a look when you’re adding load.
  • No room for the breakers the new work needs. Sometimes a sub-panel solves that without a new service.

What isn’t a sign on its own: a panel that’s old but dry, tight and correctly sized, or a “100 A is too small” rule of thumb. The Redwood Energy all-electric retrofit guide argues a 100 A panel can serve full electrification of a 3,000 ft² house with efficient equipment. That’s a published position, not a code rule, but it shows why the calculation matters more than the number on the main.

What does going from 100 A to 200 A involve?

A service upgrade replaces the equipment between the utility’s wires and your breakers, and the utility has to take part because its meter comes out. Where the meter and the main breaker share one enclosure on the outside wall, “upgrading the panel” means a new meter/main combination plus whatever interior panel it feeds.

Laguna Niguel’s handout for meter-panel replacements is a good picture of what an inspector checks. It asks for a clear working space 36 inches deep and 30 inches wide in front of the equipment, a meter between 4 ft 6 in. and 6 ft 3 in. above finished grade, a grounding conductor sized to the new panel rating, bonds to the water and gas piping, and a Ufer or ground-rod clamp that’s secure and accessible. That handout cites an older code edition, so read it as one city’s checklist rather than the current code text.

The order of a residential service upgrade
StepWhoWhat happens
1. Load calculationElectricianAdds up the house plus what you’re adding under NEC 220.83, or uses 12 months of utility data under 220.87. This decides whether you need 200 A at all.
2. Utility requestElectrician or owner, with the utilitySDG&E’s online form asks for the current and proposed panel size and the added loads. SCE requests go through its project request portal.
3. PermitCity building departmentLaguna Niguel, for one, won’t issue the permit until it has a copy of the SDG&E or SCE service order.
4. DisconnectUtilityScheduled with the utility’s planner. The house is without power until the reconnect.
5. InstallElectricianNew meter/main or panel, grounding sized to the new rating, bonds to the water and gas pipes, and the required clear working space in front of it.
6. InspectionCity inspectorThe city inspects before the meter is released back to the utility.
7. ReconnectUtilityThe utility sets the meter and restores power.

We do the load calculation, pull the permit, coordinate the utility and do the installation, so the utility and the inspector deal with us rather than you.

How do SDG&E and SCE handle a service upgrade?

Both utilities want to know what you have now and what you’re going to. SDG&E’s service request form asks for the service address, property type, owner information, the services requested and, for electric work, “current and proposed panel size and additional loads.” SDG&E’s own page says the process “can take several weeks depending on the complexity of required changes.”

SCE routes requests through its project request portal, where you pick a project type and it tells you what documents to attach, such as equipment load requirements. For a same-size panel replacement it has a separate request type to remove and reinstall the meter’s lock ring. SCE doesn’t publish a residential timeline on those pages, so we won’t guess one.

Not sure which one serves your street? The utility finder sorts it out by town. Because Laguna Niguel won’t issue a permit without the utility’s service order, the utility request goes in first.

Is a permit required for a panel upgrade?

Yes. Laguna Niguel’s handout for meter-panel replacements says it plainly: an electrical permit is required, the inspection card gets posted on site, and a copy of the SDG&E or SCE service order is required before the permit is issued. The inspection happens before the meter is released back to the utility, so the utility won’t reconnect uninspected work.

The code behind it is the 2025 California Electrical Code, Title 24 Part 3, effective January 1, 2026 and based on the 2023 NEC. Your city adopts it and its inspector has the final word on how it applies. The permit checker shows what your city asks for.

What can you try before paying for a bigger service?

Start with the calculation, then work down this list. Each step is cheaper and quicker than new service equipment, and any one of them can be enough.

  • Run 220.83 properly. It counts 3 VA per square foot, 1,500 VA per kitchen and laundry circuit and each electric appliance’s nameplate, then takes everything past the first 8,000 VA at 40 %. It’s the number an inspector will ask for anyway.
  • Use your utility data (220.87). If a year of peak-demand data is available, the code lets you use the highest demand × 125 % instead of the estimate. Your SDG&E or SCE Green Button download is where it comes from. This one doesn’t suit houses with solar, since the meter sees net flow.
  • Manage the EV load. NEC 625.42 lets an energy management system throttle a charger when the house is busy, and lets a charger’s maximum be set lower with restricted access, say 32 A on a 40 A circuit instead of 48 A on a 60 A.
  • Cap the whole service. Under NEC 220.70, a listed energy management system that limits the service lets the calculation use its setpoint. Smart panels and load controllers that are listed for this fall here. Ask whether your inspector has accepted one before you buy.
  • Share a circuit. Circuit-sharing devices let two 240 V loads, like a dryer and a charger, use one circuit by never running both at once.
  • Pick lighter equipment. Redwood Energy lists a 120 V plug-in heat pump water heater at 900 W, a fraction of a resistance tank.

When none of that closes the gap, the upgrade is the right answer, and it’s better done once, sized for what’s coming next, than twice.

What does solar have to do with your panel?

A lot. When solar or a battery connects on the load side of the main breaker, the panel’s busbar can be fed from both ends. The 120 % rule in NEC 705.12 limits that: 125 % of the inverter’s output current plus the main breaker can’t exceed 120 % of the busbar rating. On a 200 A busbar with a 200 A main, that’s 240 A − 200 A = 40 A of backfeed breaker, or 32 A of inverter output.

A 100 A busbar with a 100 A main leaves 120 A − 100 A = 20 A of backfeed breaker, or 16 A of inverter output, which is why a panel upgrade shows up in so many solar proposals. It isn’t the only fix; alternatives include a smaller main breaker (if the load calculation allows it) and a supply-side connection. The solar panel capacity checker runs those numbers. We do the electrical side alongside your solar installer.

How much does it cost, and how long does it take?

We don’t publish prices, because the variables that drive a panel upgrade (where the meter is, what the utility needs to change, how much of the house wiring has to be reconnected, whether there’s stucco to open) are different at every address. Text a photo of the panel and the meter and you’ll get a real number.

On timing, the only published figure we found is SDG&E’s: several weeks, depending on the complexity of the changes. The installation day itself is scheduled around the utility’s disconnect and the city’s inspection, and the house is without power between the disconnect and the reconnect. If you’re planning an EV purchase or a heat pump around the upgrade, file early.

Questions

Common questions

Can I add an EV charger without upgrading my 100 amp panel?

Often. A 2,000 ft² gas-cooking house with central air and a 48 A charger calculates at 74.2 A under the NEC 220.83 text. Where the math doesn’t fit, a lower charger setting or an energy management system under NEC 625.42 can. Run the panel load calculator with your own appliances before accepting a quote for a service upgrade.

Who contacts SDG&E or SCE for a panel upgrade?

Usually the electrician, because the utility asks for technical details: the current and proposed panel size and the added loads. We file the request, schedule the disconnect and reconnect, and coordinate the city inspection in between.

How long does SDG&E take for a service upgrade?

SDG&E says the process can take several weeks depending on the complexity of the required changes. SCE doesn’t publish a residential timeline on its request pages. Filing the utility request early is the best way to keep the job on schedule.

Do I need to replace a Federal Pacific or Zinsco panel even if I’m not adding anything?

Insurers say yes: The Hanover recommends replacing Stab-Lok with a completely new panelboard, and Great American recommends replacing Zinsco after an electrician inspects it. Those are equipment concerns, separate from whether the service is big enough.

Does a panel upgrade need a permit in California?

Yes. Cities treat a service change as permitted work under the 2025 California Electrical Code, and the inspector signs off before the utility reconnects the meter. Laguna Niguel also requires a copy of the utility’s service order before it issues the permit.

Sources

Where this comes from

  1. City of Laguna Niguel — Handout 128, Electric Meter Panel ReplacementsElectrical permit and posted inspection card required; a copy of the SDG&E or SCE service order required before the permit is issued; 36 in. deep by 30 in. wide working space; meter height 4 ft 6 in. to 6 ft 3 in.; grounding conductor sized to the panel rating; water and gas pipe bonds; inspection before the meter is released to the utility. The handout cites an older code edition, so treat the specifics as that city’s checklist (read Sep 22, 2026).
  2. SDG&E — Service Planning for Expansion or RelocationOnline service request form asks for current and proposed panel size and additional loads; “The process can take several weeks depending on the complexity of required changes” (read Sep 22, 2026).
  3. SCE — Power Requests and UpgradesRequests start at sce.com/projectrequest with an application and supporting documentation such as equipment load requirements (read Sep 22, 2026).
  4. SCE — Project Requests: Construction and RenovationLists a “Lockring Removal/Reinstall for Panel Upgrade” request type (read Sep 22, 2026).
  5. California Building Standards Commission — Codes (2025 Title 24)2025 California Building Standards Code effective January 1, 2026; Part 3 is the California Electrical Code (read Sep 22, 2026).
  6. HCAI Initial Statement of Reasons, 2025 California Electrical CodeThe 2025 CEC adopts the 2023 NEC (read Sep 22, 2026).
  7. Electrical Contractor — Branch-Circuit, Feeder and Service Calculations, Part LIINEC 220.83 existing-dwelling calculation: 3 VA/ft², 1,500 VA circuits, nameplates, first 8 kVA at 100 % and the rest at 40 %; A/C or heat at 100 % when added (read Sep 22, 2026).
  8. Electrical Contractor — Mark C. Ode, “When a Local Requirement Went National” (May 14, 2024)NEC 220.87: a year of maximum-demand data, usually from the utility, × 125 % plus the new load (read Sep 22, 2026).
  9. Leviton Captain Code (2023 NEC) — 220.70 Energy Management SystemsAn EMS that limits a service per 750.30 lets the load calculation use its maximum ampere setpoint (read Sep 22, 2026).
  10. ExpertCE — How 2023 NEC changes affect EVSE load calculations625.42(A) energy management systems and 625.42(B) restricted-access adjustable settings on EV chargers (read Sep 22, 2026).
  11. Redwood Energy — A Pocket Guide to All-Electric Retrofits of Single-Family HomesArgues a 100 A panel can serve full electrification of a 3,000 ft² home with efficient equipment; 120 V heat pump water heater at 900 W; circuit-sharing devices (read Sep 22, 2026).
  12. Mayfield Renewables — Code Corner: 2020 NEC 705.12(B)(3)(1) and (2)120 % rule: 125 % of inverter output current + main breaker ≤ 120 % of busbar rating; 200 A busbar and 200 A main allows 32 A of inverter current (40 A) (read Sep 22, 2026).
  13. The Hanover Insurance Group — Federal Pacific Electric (FPE) Stab-LokRecommends replacing Stab-Lok with a completely new panelboard (read Sep 22, 2026).
  14. Great American Insurance Group — Is Your Electric Panel a Fire Risk?Recommends replacing Zinsco panels after inspection by a licensed electrical contractor (read Sep 22, 2026).
  15. IAEI Magazine — The 6-Disconnect Rule (2020)2020 NEC requires a main disconnect in each service panelboard (read Sep 22, 2026).
  16. SDG&E — Download My Green Button DataHow to download interval usage from My Energy Center (read Sep 22, 2026).
  17. SCE — Energy Management CenterGreen Button Download of hourly and daily usage (read Sep 22, 2026).

Last reviewed . General information, not a design or legal advice — your inspector and your city’s adopted code edition have the final word.
